Manufacturing

01

One cycle connects the order, the materials, production, and cost

Manufacturing management does not start at the production order, and it does not end when the finished product is received into stock.

Before the factory moves, the system has to know: what needs to be made? Why? To what specification? Are the materials available? Which line will run it? And when must it be done?

During execution, it has to record what was actually issued, what was produced, what stopped or went back for rework, and what passed or failed inspection.

And in the end, knowing the quantity produced is not enough. The system must know the product's actual cost, the order or customer it was made for, and when it became available to sell or deliver.

02

Not every factory works the same way

Before designing the operating cycle, decide what triggers production inside the factory.

Make to stock (MTS)

Items are produced ahead of demand and held in stock until a customer order arrives.

The system watches stock thresholds, consumption rates, and forecast demand, then proposes production orders before you run out.

This model suits standard, repeat products sold to the same specification every time.

Make to order (MTO)

The manufacturing order starts when the customer order is confirmed.

The system links the sales order directly to the production order, its materials, and its delivery date, so nothing is produced without a real order behind it.

Engineer to order (ETO)

The final product is not fully defined at first contact with the customer.

The cycle starts with a site visit or measurements, then design, pricing, and customer approval. Only once the specification is locked is the BoM built and manufacturing started.

Every order here is its own project: product, dimensions, components, and cost can differ from one customer to the next.

Subcontract manufacturing

The company may own the materials and the design while one or more stages run at an external factory or workshop.

The system tracks the materials held at each subcontractor, the operations in progress, quantities received, quality, what the vendor is owed, and the product cost once processing fees are added.

A company may run more than one model at once: standard products built for stock, products made to order, and custom orders that need design and approval first.

What matters is never forcing every product through a single manufacturing cycle that does not fit it.

03

The product comes before the manufacturing order

The cycle starts by defining what gets made, what it needs, and how it moves through the factory.

The product record covers:

The finished item and its variants: color, size, model.
Raw materials and components.
Purchase, issue, and production units of measure.
Drawings and technical specifications.
Lot or serial numbers where needed.
Sourcing policy: buy, make in-house, or subcontract.
Inventory valuation and costing method.
Quality control points.
Packaging materials.

The bill of materials (BoM)

The BoM states which materials and quantities the product needs, and what it yields: the finished product and any by-products.

An item can carry more than one BoM, depending on size, revision, or customer specification.

The standard recipe is not edited every time a different order shows up. The original stays intact. An approved change gets its own version or configuration.

The routing

The routing defines the operations the product passes through, for example:

Cutting → Forming → Assembly → Finishing → Inspection → Packing

Each operation has a work center, an expected time, a sequence, and an approval, and one operation may need to finish before the next can start.

That way the BoM is not just a list of materials; it is a complete description of how the product leaves the factory.

Inside Odoo

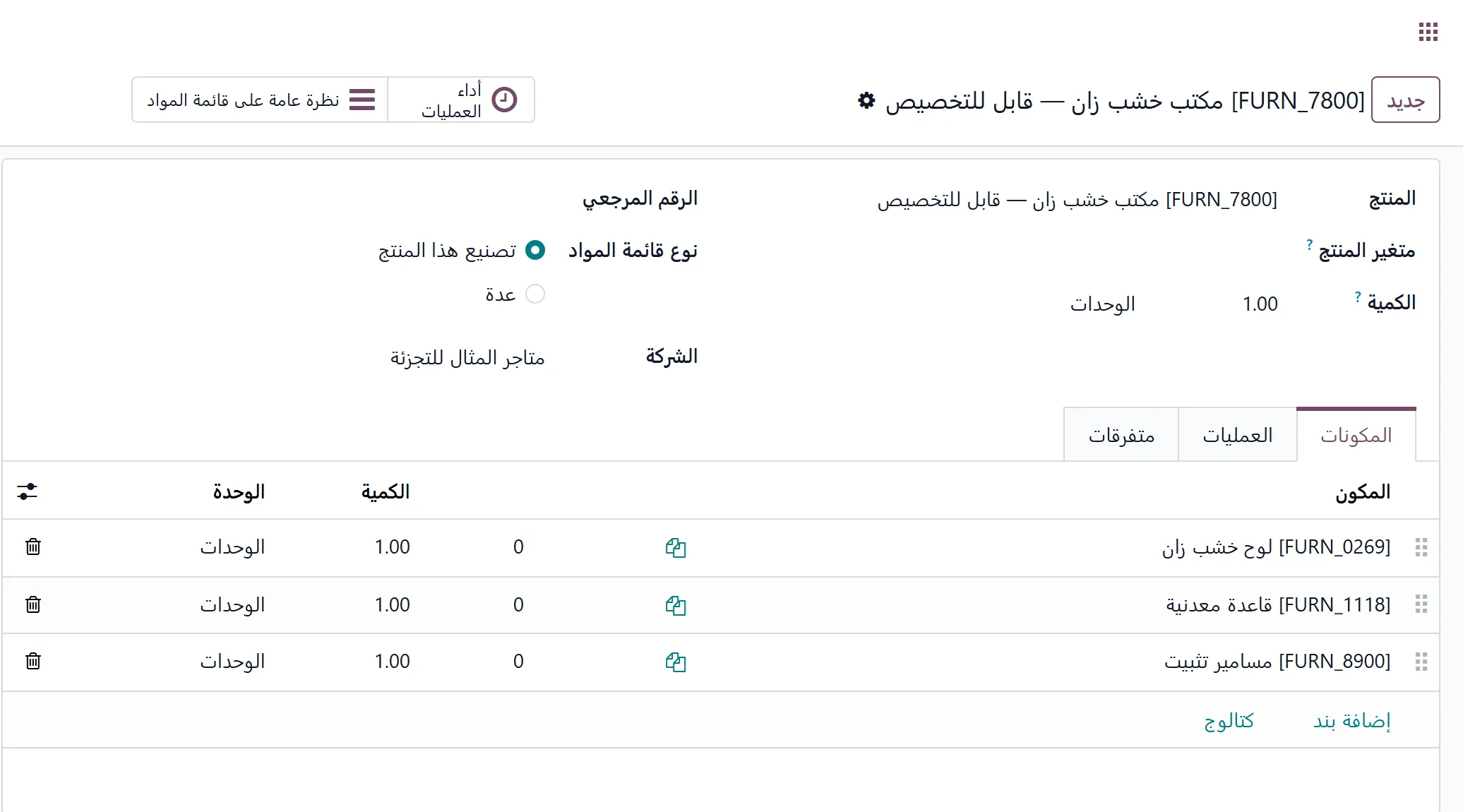

A product's bill of materials with its components in Odoo
The product's bill of materials: components and quantities per unit produced, the basis for costing and material issues.
04

From the order to the production plan

The need can start from a customer order, a stock dip, a sales plan, or a project with a delivery date.

The system gathers these requirements, then checks them against:

Available stock.
Materials reserved for other orders.
Purchases awaiting receipt.
Work in progress.
Available capacity at each work center.
Customer delivery dates.

From there, the required production orders emerge, with their dates and priorities.

A material being on site is not enough. It may already be reserved for another manufacturing order. Planning therefore runs on what is available after reservations, not the gross balance alone.

Inside Odoo

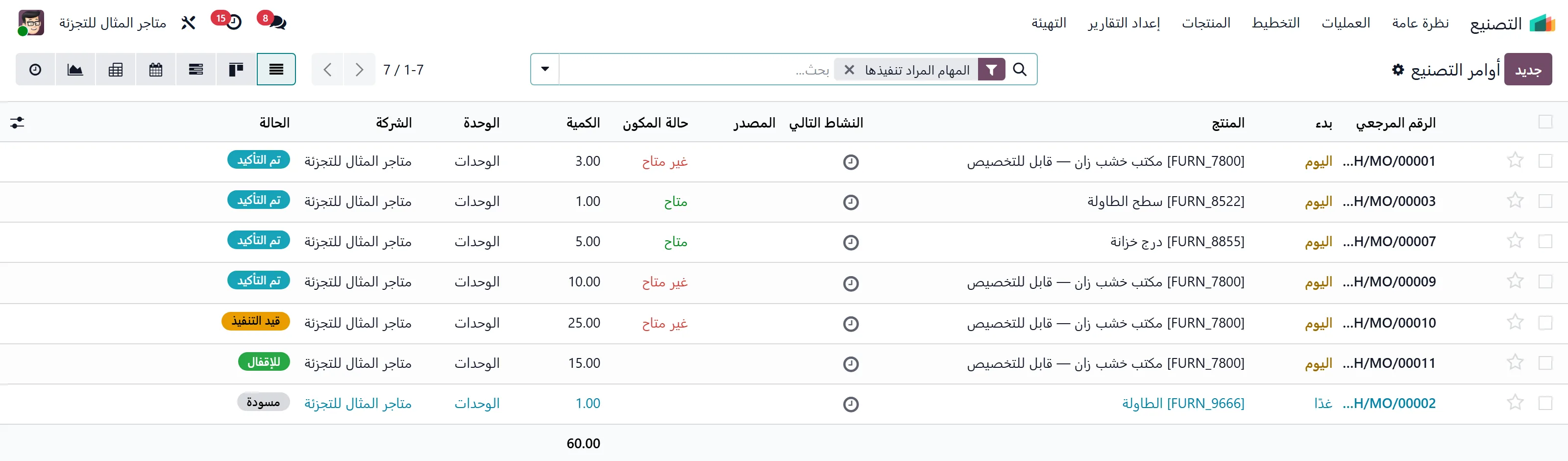

Manufacturing orders and their statuses in Odoo
Manufacturing orders by status (confirmed, in progress, to close) with component availability for each order before it starts.
05

Materials planning and purchasing

When a production order is confirmed, the system calculates the materials required and compares them to what is available.

Any shortfall surfaces to purchasing, with the quantities needed and the arrival date that keeps production starting on time.

Purchasing runs from the requisition to purchase order approval, then receipt, inspection, the vendor bill, and payment.

And every purchase ties back to a clear reason:

A customer order. A manufacturing order. Stock replenishment. Machine maintenance. An operational need. A subcontracting agreement.

What a material really costs

A material's cost is not just the vendor's price.

On purchases and imports, freight, insurance, customs, transport, and other charges can be added to the shipment's cost, then spread across its items.

The material enters the factory at its true value, so a product never looks profitable just because part of its cost was left outside inventory.

06

Receiving materials

When materials arrive, the quantity received is matched against the purchase order, and any shortage, excess, or damage is recorded.

A material may pass through inspection before it becomes available to production.

Based on the result, it moves to:

Available stock. Under inspection. Rejected, awaiting return. Damaged. Needs treatment or rework.

In industries that need traceability, the lot or serial number and expiry date are recorded, so for every material you can trace the vendor, the shipment, and each product it went into.

07

Scheduling the factory

Once materials are confirmed, manufacturing orders are scheduled across the lines and work centers.

Scheduling depends on:

Order priority.
Delivery date.
Available capacity per line or machine.
Run time and setup time.
Dependencies between operations.
Maintenance and planned downtime.
Labor and required skills.

A production order can hold several work orders, so each department knows exactly what is expected of it: the quantity, the deadline, what comes before it, and what comes after.

A delay in one stage shows its effect on the following stages and the delivery date, instead of the problem surfacing only after the deadline has passed.

08

Execution on the shop floor

When a run starts, materials are issued to that specific manufacturing order, not as a general factory expense.

The production team records:

Start and end time of each operation.
Quantity produced.
Quantity rejected or scrapped.
Materials actually consumed.
Materials returned to the warehouse.
The worker or team who ran it.
The machine or work center.
The reason for any stoppage.
Notes or photos attached to the run.

Actual quantities can differ from the theoretical BoM. The system keeps both, so expected consumption can be compared against what was actually used.

And nobody waits for the end of the shift to enter everything from memory or paper. That lag disconnects the system from what is actually happening on the floor.

Inside Odoo

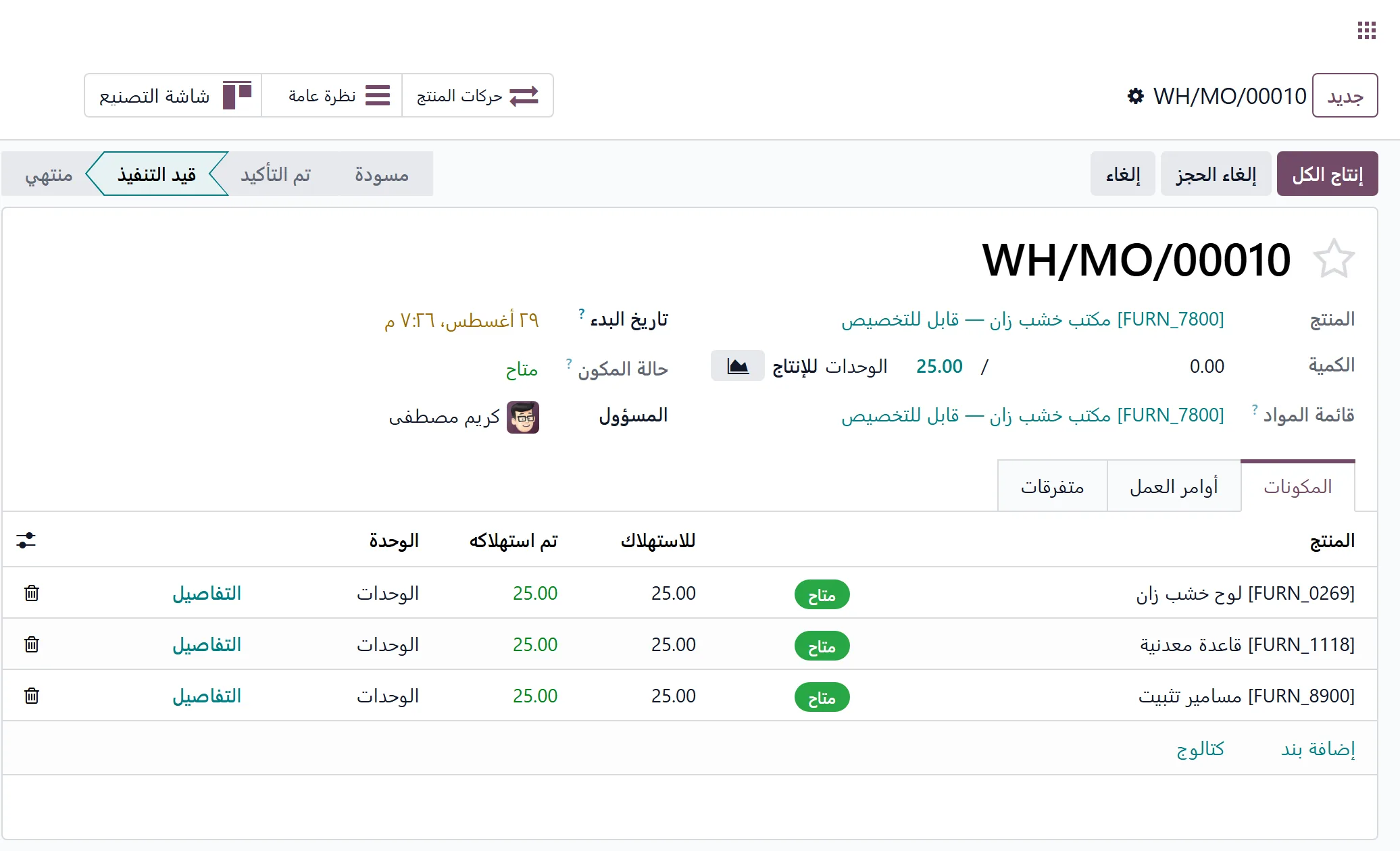

A manufacturing order in progress with its components in Odoo
A manufacturing order in progress: the quantity to produce, the components reserved for it, and their availability at the moment of execution.
09

Work in progress (WIP)

Materials that left the warehouse have not instantly become finished product.

They may be in cutting, in assembly, at an external subcontractor, waiting for inspection, or due for rework.

The system shows the quantities in progress, where they are, which stage they have reached, and how long they have been there.

So you can answer:

What has started but not finished?
Where is each quantity right now?
Which stage is running late?
What is the value of materials in WIP?
Which orders are blocked by a material, quality, or machine issue?
What is expected to finish each day or shift?
10

Quality is not just a final check

Quality can start at material receipt, repeat during production, then run once more before the finished product enters stock.

Check points can vary by product or operation:

A measurement or numeric value. Pass / fail. A photo. A checklist of questions. A sample of the quantity. Full inspection of every piece.

When a check fails, the result does not sit as a note. The quantity moves down a defined path:

Rework or repair. Re-inspection. Downgrade. An approved substitute. Return to vendor. Scrap.

The failure reason, the stage, the machine, the vendor, the worker, and the photos stay attached to the case, so you can trace the defect to its source and stop it recurring.

11

Engineer to order (ETO)

With engineered or custom products, the factory does not start from a generic quotation.

The process usually runs:

Inquiry → Site visit & measurements → Design → Pricing → Customer approval → Contract → Technical review → Custom BoM → Manufacturing → Installation or handover

Each customer order is treated as its own project, holding:

Measurements and drawings.
Design revisions.
Customer approvals.
The quotation and its amendments.
The custom bill of materials.
Manufacturing orders.
Related purchases and subcontracts.
Photos and quality results.
Installation and handover.
Payments, cost, and profitability.
Warranty and after-sales service.

Controlling changes

The most dangerous moment in engineer-to-order work is a design, dimension, or material changing after purchasing or production has already started.

So the system keeps clear revisions, and no change reaches the factory before it is approved and its impact is defined on:

Price. Materials. Delivery date. Operations already performed. Scrap or rework. What the customer owes.

That way the engineering office is never working on one revision while the factory builds another.

12

Subcontract manufacturing

When stages run at an external vendor or workshop, the materials and work in progress still belong to the company, and they must stay visible in the system.

The company may ship its materials to the external factory, or the intermediate product may move straight from one vendor to the next for the following stage.

The system tracks:

Materials sent to each factory.
Quantities currently held there.
The subcontract order and the operation required.
The delivery date.
The intermediate product it yields.
Its move to the next stage.
Damaged quantities and those needing repair.
Inspection results on receipt.
What the subcontractor is owed.
The processing cost added to the product.

Even when a product passes through several factories, its trail stays connected from the first material to the finished product, instead of each stage showing up as a separate purchase that cannot be tied to what came before it.

13

Packing and the finished product

After manufacturing and inspection, a product may still need final assembly, a box, a label, or accessories.

Packing is treated as part of the manufacturing cycle whenever it consumes materials and changes the sellable form of the product.

Once complete, the finished product enters stock with its quantity, lot, and actual cost.

It then becomes available to the order it was made for, or to general stock, if it was made to stock.

A product never shows as available to sell before its operations, inspection, and packing are done.

14

Multiple plants and lines

When a company runs more than one plant or station, each site can operate with its own stock, lines, and production orders, while management stays on one system.

The sales order, the customer's region, or the product type determines which plant fulfills the order.

And each plant shows:

Its stock and materials. Its production orders. Available capacity. Purchases and vendors. Assets and machines. Expenses and depreciation. Output and scrap. Revenue, cost, and profitability.

One system does not mean blended numbers. Each site stays visible on its own, and the company rolls up as a whole.

15

Installation and handover

In some industries, the cycle does not end at the factory gate: there is transport to schedule and installation at the customer's site.

The system ties the installation date to product readiness, the crew, the vehicle, the customer's location, and the payments due before work starts.

The installation team records:

Departure and arrival times.
Products and components delivered.
Work performed.
Notes and photos.
Any extras the customer requested.
Work still to be completed.
Sign-off or approval of the handover.

New work is never added to the original order verbally. It gets recorded, and its impact on price, time, and cost is set before it is executed.

Once handover is complete, warranty or maintenance begins per the product policy and the contract.

16

Maintenance protects the production plan

One broken machine can delay several manufacturing orders, so maintenance is never managed apart from the factory plan.

The system keeps a record for every machine or asset, covering:

The asset’s location and condition.
The preventive maintenance schedule.
Past breakdowns.
Spare parts used.
Downtime.
The technician responsible.
Repair cost.
The next maintenance date.

When a machine goes down, the impact shows on its work center and the orders scheduled on it, and the schedule can be rebuilt, instead of the plan carrying on as if the capacity were still there.

17

Product cost

Manufacturing cost is not computed from theoretical materials alone.

Depending on the business, product cost is built from:

Materials actually consumed.
Freight and landed costs.
Labor time.
Machine and work-center time.
Subcontracting fees.
Packaging materials.
External services and operations.
Scrap and rework.
Overhead allocated per policy.

You can then compare:

Expected cost → Actual cost → The variance and its cause

In make-to-order work, cost accumulates on the customer order or project itself, so each order shows its own profitability, not just a product-wide average.

Repeat products follow the approved inventory valuation method (standard cost, average, or FIFO) per the company's nature and accounting policies.

Inside Odoo

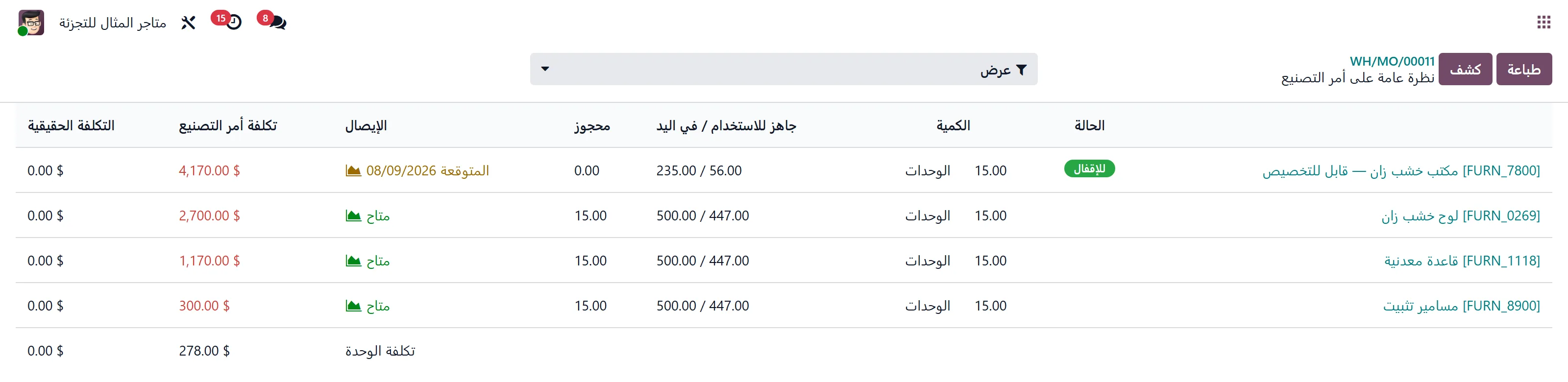

Cost analysis of a manufacturing order in Odoo
The manufacturing order's cost as the system computes it: the cost of each component, the order total, and the unit cost of the finished product.
18

How operations hit the books

Every completed movement in operations creates its financial impact at the source.

A purchase records the vendor liability. Receiving a material raises inventory value. Issuing it moves that value into work in progress. Finishing manufacturing moves the cost into finished goods. And the sale records revenue and cost of goods sold.

And each shows separately:

The value of raw materials.
The value of work in progress.
The value of finished goods.
Amounts owed to vendors and subcontractors.
Cost of goods sold.
Scrap and rework.
Manufacturing overhead.
Profitability by product, order, project, and plant.

The accountant never has to rebuild product cost from purchasing, warehouse, and production files at month end. Those departments recorded each cost at its source, as it happened.

19

Who owns the decision?

One person may hold several roles depending on the factory's size, but every decision must have a clear owner.

Sales / project management
Decisions they own
The customer order, commercial specs, delivery date, and order priority.
Design & engineering office
Decisions they own
Drawings, dimensions, revisions, the bill of materials, and technical specifications.
Production planning
Decisions they own
Production orders, priorities, scheduling, and allocating work across lines.
Purchasing
Decisions they own
Vendors, purchase orders, prices, and delivery dates.
Warehouse
Decisions they own
Receiving, issuing, returns, transfers, inventory counts, and lot tracking.
Production supervisor
Decisions they own
Starting work orders, assigning work, and logging output and stoppages.
Operator / machine worker
Decisions they own
Running the operation and logging time, quantity, and notes within their access rights.
Quality
Decisions they own
Inspection results, rejections, rework, and product release.
Maintenance
Decisions they own
Preventive maintenance, breakdowns, spare parts, and machine readiness.
Cost Control
Decisions they own
Expected vs. actual cost, variances, and order and project costing.
Finance
Decisions they own
Vendors, inventory, work in progress, journal entries, valuation, and profitability.
Installation / delivery
Decisions they own
Scheduling, site visits, work performed, and handover reports.

Some decisions involve more than one department, but a single party still owns starting the decision and seeing it through.

20

Controls above the factory floor

Recording what was produced is not enough. Every change and every exception must be reviewable.

The system relies on:

Access rights and approvals

Define who can change a recipe, substitute a material, over-issue, approve scrap, move a production date, or close a manufacturing order.

Audit trail

Records who changed the data, when, the value before and after, and why.

Document versions

Keep design revisions, BoM versions, and work instructions in sync, so no department works from a different copy.

Stoppage and variance reasons

A delay or over-consumption is never logged as a bare difference; it is tied to a cause you can analyze: material, machine, quality, labor, or planning.

21

What does management track?

Factory metrics depend on connecting the order, the materials, production, quality, and cost.

The key indicators include:

Planned, running, and late production orders.
On-time delivery.
Used vs. available capacity per line.
Run time, downtime, and its causes.
Actual vs. planned output.
Actual material consumption vs. the BoM.
Scrap and rework.
Quality results and rejection rate.
Work in progress and where it sits.
Materials held at subcontractors.
Unit cost and order profitability.
Vendor performance and delivery dates.
Value of materials, WIP, and finished goods.
Maintenance, breakdowns, and machine downtime.
22

What does Odoo actually run?

Odoo brings into one cycle:

Products, variants, specifications, and drawings.
Bills of materials and their versions.
Routings and work centers.
MTS, MTO, and ETO by product type.
Requirements and materials planning.
Purchasing, receiving, and landed costs.
Warehouses, lots, and serial numbers.
Manufacturing orders and work orders.
Material issues, output, scrap, and returns.
Work in progress.
Quality, rework, and repair.
Subcontract manufacturing.
Packing and finished goods.
Multiple plants and lines.
Preventive maintenance and breakdowns.
Installation, handover, and warranty where relevant.
Cost by product, customer order, and project.
Accounting, inventory, and management reporting.
Access rights, approvals, and the audit trail.

As for the recipes, scrap rates, run times, line capacity, quality points, scheduling rules, and how overhead gets allocated, those are set during the factory analysis. A manufacturing system has to reflect how you actually produce, not a fixed generic template.
